Why your budget is a range
PlanAll plans, including Free
A single figure for a build cost looks tidy, but it claims a certainty nobody has before the work is done. Self Build Budget gives each line a low and a high, then adds them up to a cost range, so your totals show how sure you are. Your budget is different: it is one figure that you lock, never a range.
Steps
- Open the Estimate page. On a desktop, choose Estimate in the menu on the left. On a phone, tap the Budget tab at the bottom of the screen, then the Estimate tab at the top.
- Look at the figure under Estimate (ex VAT). It is a range because it comes from a Low rate per m² and a High rate per m². In the example, 200 m² at £2,000.00 and £2,400.00 gives £400,000 to £480,000.

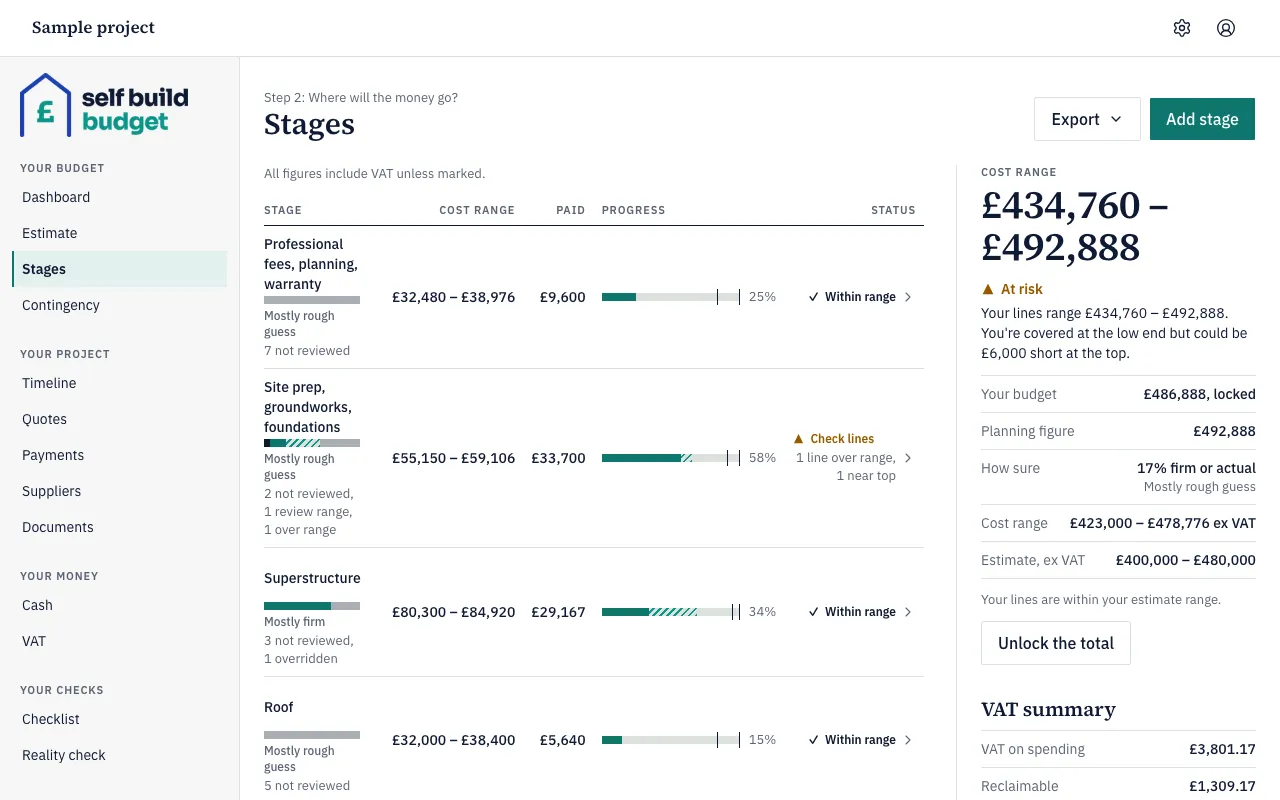

- Open the Stages page. On a desktop, choose Stages in the menu on the left. On a phone, tap the Budget tab at the bottom, then the Stages tab at the top.
- Read the Cost range column. Each stage shows its low and high, including VAT. A stage’s low and high are the sums of its lines’ lows and highs. In the example, Superstructure is £80,300 to £84,920.
- Look under each stage name and in the Status column. A label such as “Mostly rough guess” or “Mostly firm” shows how sure the stage’s figures are. A status such as Within range or Check lines shows whether anything has gone over.
- Read the panel on the right. In the example, Cost range is £434,760 to £492,888 and Planning figure is £492,888. Your budget is £486,888, locked. The panel shows At risk because the budget covers the low end but could be £6,000 short at the top.

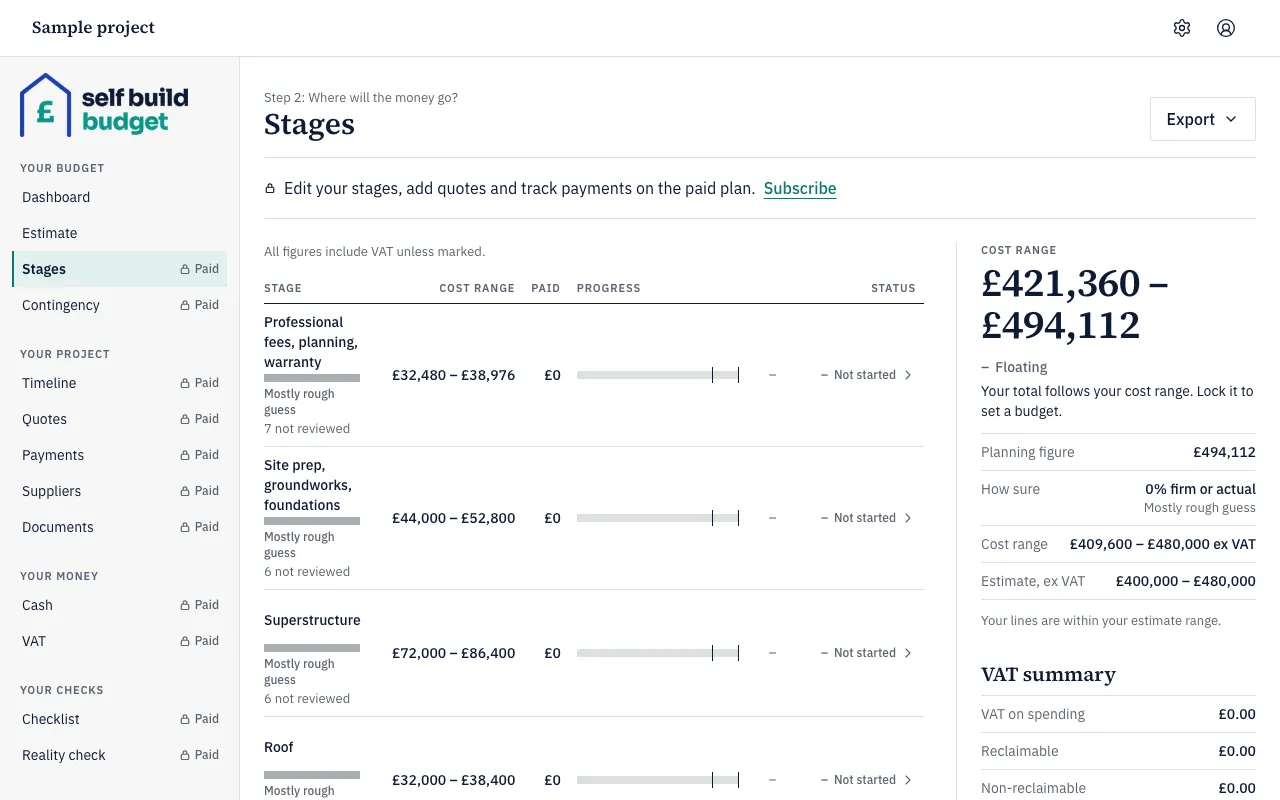

- On Free, Stages opens as a read-only preview of your own stages and lines, with a lock beside it. Editing stages needs Standard. The total shows Floating until a budget is locked. The Dashboard on Free also shows Cost range, Planning figure, Your budget and How sure. See Read your Dashboard.
Good to know
- One figure hides the spread. A kitchen guessed at £25,000 to £40,000 ex VAT shows as £30,000 to £48,000 including VAT. A single £30,000 would hide how far it could go. Each line also shows its range ex VAT, marked “ex VAT”.
- Reality moves the range. Payments and accepted quotes above a line’s high push its cost range up, and the line is marked as over range. For example, a drainage line guessed at £8,000 to £12,000 with £12,900 of accepted quotes becomes £12,900 to £12,900. The range can also fall, for example when you lower a line’s figures or a variation reduces a quote.
- The planning figure is the top of the whole project’s cost range. A line or a stage doesn’t have one. For example, a cost range of £410,000 to £480,000 has a planning figure of £480,000. The app uses it wherever a single number is needed, such as the cash flow and exports.
- Your budget is one figure, including VAT, that you lock. Until you lock it, the total follows your cost range. See Lock or float your budget.
- Check the VAT basis. Estimate figures exclude VAT. Stages figures include VAT unless marked.
- How sure tells you how much weight to give a line’s range: Rough guess, Quoted, Firm or Actual. A line marked Not reviewed still holds the starting figures from your estimate. See How sure: Rough guess, Quoted, Firm and Actual.
The figures in the app are a guide, not financial or tax advice.
